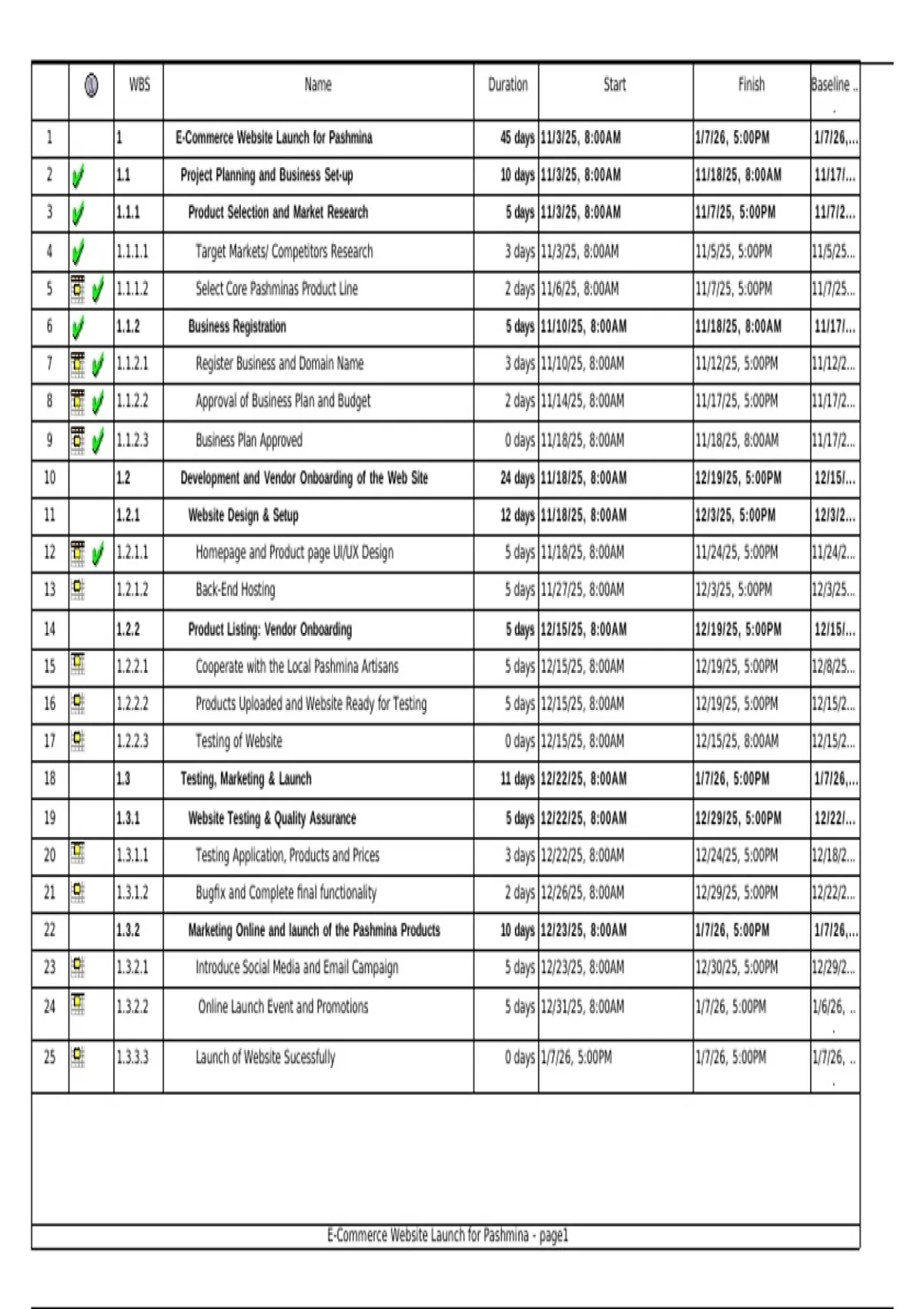

WBS Name Duration Start Finish Baseline ..
.
1 1 E-Commerce Website Launch for Pashmina 45 days 11/3/25, 8:00AM 1/7/26, 5:00PM 1/7/26,...
2 1.1 Project Planning and Business Set-up 10 days 11/3/25, 8:00AM 11/18/25, 8:00AM 11/17/...
3 1.1.1 Product Selection and Market Research 5 days 11/3/25, 8:00AM 11/7/25, 5:00PM 11/7/2...
4 1.1.1.1 Target Markets/ Competitors Research 3 days 11/3/25, 8:00AM 11/5/25, 5:00PM 11/5/25...
5 1.1.1.2 Select Core Pashminas Product Line 2 days 11/6/25, 8:00AM 11/7/25, 5:00PM 11/7/25...
6 1.1.2 Business Registration 5 days 11/10/25, 8:00AM 11/18/25, 8:00AM 11/17/...
7 1.1.2.1 Register Business and Domain Name 3 days 11/10/25, 8:00AM 11/12/25, 5:00PM 11/12/2...
8 1.1.2.2 Approval of Business Plan and Budget 2 days 11/14/25, 8:00AM 11/17/25, 5:00PM 11/17/2...
9 1.1.2.3 Business Plan Approved 0 days 11/18/25, 8:00AM 11/18/25, 8:00AM 11/17/2...
10 1.2 Development and Vendor Onboarding of the Web Site 24 days 11/18/25, 8:00AM 12/19/25, 5:00PM 12/15/...
11 1.2.1 Website Design & Setup 12 days 11/18/25, 8:00AM 12/3/25, 5:00PM 12/3/2...
12 1.2.1.1 Homepage and Product page UI/UX Design 5 days 11/18/25, 8:00AM 11/24/25, 5:00PM 11/24/2...
13 1.2.1.2 Back-End Hosting 5 days 11/27/25, 8:00AM 12/3/25, 5:00PM 12/3/25...
14 1.2.2 Product Listing: Vendor Onboarding 5 days 12/15/25, 8:00AM 12/19/25, 5:00PM 12/15/...
15 1.2.2.1 Cooperate with the Local Pashmina Artisans 5 days 12/15/25, 8:00AM 12/19/25, 5:00PM 12/8/25...
16 1.2.2.2 Products Uploaded and Website Ready for Testing 5 days 12/15/25, 8:00AM 12/19/25, 5:00PM 12/15/2...
17 1.2.2.3 Testing of Website 0 days 12/15/25, 8:00AM 12/15/25, 8:00AM 12/15/2...
18 1.3 Testing, Marketing & Launch 11 days 12/22/25, 8:00AM 1/7/26, 5:00PM 1/7/26,...
19 1.3.1 Website Testing & Quality Assurance 5 days 12/22/25, 8:00AM 12/29/25, 5:00PM 12/22/...
20 1.3.1.1 Testing Application, Products and Prices 3 days 12/22/25, 8:00AM 12/24/25, 5:00PM 12/18/2...
21 1.3.1.2 Bugfix and Complete final functionality 2 days 12/26/25, 8:00AM 12/29/25, 5:00PM 12/22/2...
22 1.3.2 Marketing Online and launch of the Pashmina Products 10 days 12/23/25, 8:00AM 1/7/26, 5:00PM 1/7/26,...
23 1.3.2.1 Introduce Social Media and Email Campaign 5 days 12/23/25, 8:00AM 12/30/25, 5:00PM 12/29/2...
24 1.3.2.2 Online Launch Event and Promotions 5 days 12/31/25, 8:00AM 1/7/26, 5:00PM 1/6/26, ..
.
25 1.3.3.3 Launch of Website Sucessfully 0 days 1/7/26, 5:00PM 1/7/26, 5:00PM 1/7/26, ..
.
E-Commerce Website Launch for Pashmina - page1
,
.
1 1 E-Commerce Website Launch for Pashmina 45 days 11/3/25, 8:00AM 1/7/26, 5:00PM 1/7/26,...
2 1.1 Project Planning and Business Set-up 10 days 11/3/25, 8:00AM 11/18/25, 8:00AM 11/17/...
3 1.1.1 Product Selection and Market Research 5 days 11/3/25, 8:00AM 11/7/25, 5:00PM 11/7/2...
4 1.1.1.1 Target Markets/ Competitors Research 3 days 11/3/25, 8:00AM 11/5/25, 5:00PM 11/5/25...
5 1.1.1.2 Select Core Pashminas Product Line 2 days 11/6/25, 8:00AM 11/7/25, 5:00PM 11/7/25...
6 1.1.2 Business Registration 5 days 11/10/25, 8:00AM 11/18/25, 8:00AM 11/17/...
7 1.1.2.1 Register Business and Domain Name 3 days 11/10/25, 8:00AM 11/12/25, 5:00PM 11/12/2...
8 1.1.2.2 Approval of Business Plan and Budget 2 days 11/14/25, 8:00AM 11/17/25, 5:00PM 11/17/2...
9 1.1.2.3 Business Plan Approved 0 days 11/18/25, 8:00AM 11/18/25, 8:00AM 11/17/2...
10 1.2 Development and Vendor Onboarding of the Web Site 24 days 11/18/25, 8:00AM 12/19/25, 5:00PM 12/15/...
11 1.2.1 Website Design & Setup 12 days 11/18/25, 8:00AM 12/3/25, 5:00PM 12/3/2...
12 1.2.1.1 Homepage and Product page UI/UX Design 5 days 11/18/25, 8:00AM 11/24/25, 5:00PM 11/24/2...
13 1.2.1.2 Back-End Hosting 5 days 11/27/25, 8:00AM 12/3/25, 5:00PM 12/3/25...
14 1.2.2 Product Listing: Vendor Onboarding 5 days 12/15/25, 8:00AM 12/19/25, 5:00PM 12/15/...
15 1.2.2.1 Cooperate with the Local Pashmina Artisans 5 days 12/15/25, 8:00AM 12/19/25, 5:00PM 12/8/25...
16 1.2.2.2 Products Uploaded and Website Ready for Testing 5 days 12/15/25, 8:00AM 12/19/25, 5:00PM 12/15/2...
17 1.2.2.3 Testing of Website 0 days 12/15/25, 8:00AM 12/15/25, 8:00AM 12/15/2...
18 1.3 Testing, Marketing & Launch 11 days 12/22/25, 8:00AM 1/7/26, 5:00PM 1/7/26,...
19 1.3.1 Website Testing & Quality Assurance 5 days 12/22/25, 8:00AM 12/29/25, 5:00PM 12/22/...
20 1.3.1.1 Testing Application, Products and Prices 3 days 12/22/25, 8:00AM 12/24/25, 5:00PM 12/18/2...
21 1.3.1.2 Bugfix and Complete final functionality 2 days 12/26/25, 8:00AM 12/29/25, 5:00PM 12/22/2...
22 1.3.2 Marketing Online and launch of the Pashmina Products 10 days 12/23/25, 8:00AM 1/7/26, 5:00PM 1/7/26,...
23 1.3.2.1 Introduce Social Media and Email Campaign 5 days 12/23/25, 8:00AM 12/30/25, 5:00PM 12/29/2...
24 1.3.2.2 Online Launch Event and Promotions 5 days 12/31/25, 8:00AM 1/7/26, 5:00PM 1/6/26, ..
.
25 1.3.3.3 Launch of Website Sucessfully 0 days 1/7/26, 5:00PM 1/7/26, 5:00PM 1/7/26, ..
.
